Resource Planning Detailed Data Mapping

Overview

Customers have four options when it comes to how they manage data in Resource Planning and other Procore tools. Customers choose where they want to manage data. That data is then synced between Resource Planning and other tools in Procore. The data that is synced is listed below based on where you choose to manage your data.

Data flows between various systems are supported by:

  • Quick Connect - This integration tool syncs data from a system of record to Resource Planning.
    Note: This option is available to customers with an approved Resource Planning integration.

  • Internal Data Sync - This syncs information between the Resource Planning Tool and other tools in Procore.

  • ERP Integrations - This syncs information between a Customer's ERP system and Procore's Portfolio tool.
    Note: To purchase an ERP integration that syncs projects, Customers must also purchase Procore Financials.

  • Data Upload - This is a one-time data upload where a Customer's People and Project data is uploaded into Resource Planning.

Detailed Data Mapping

Customers have the following options available when it comes to how they manage data in Resource Planning and other Procore tools:

  1. Manage People and Projects from your System of Record.

  2. Manage People from your System of Record, Manage Projects from ERP.

  3. Manage People from Resource Planning, Manage Projects from the Portfolio tool.

Manage People and Projects from your System of Record

Customers manage people and project information in a system of record, and use QuickConnect to sync both people and projects in Resource Planning. People and project information then sync to the Company Directory and Portfolio tools.

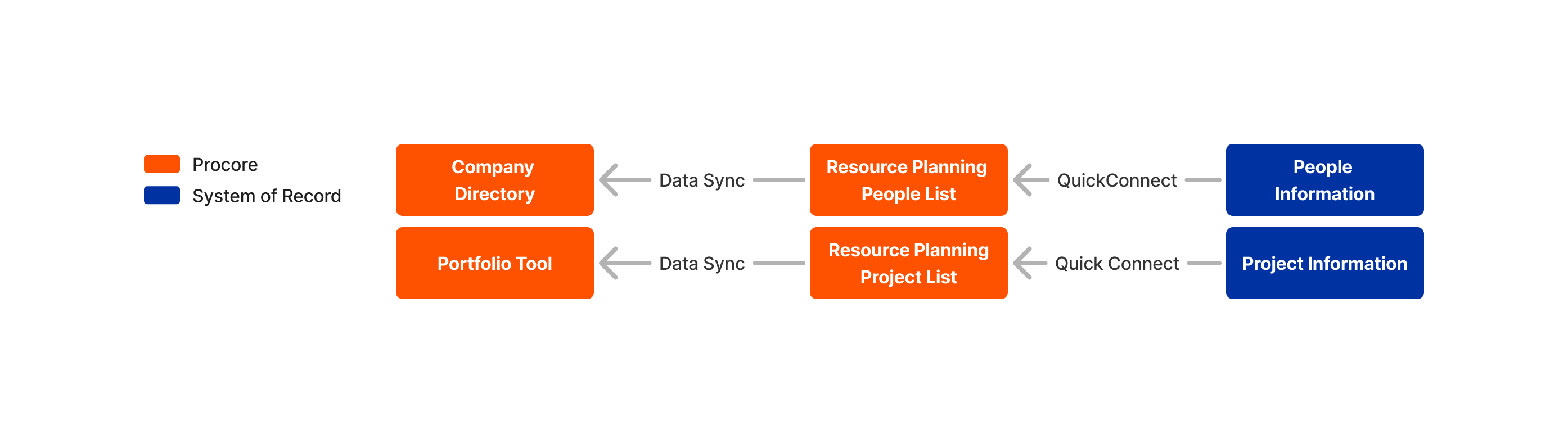

Resource Planning People and Projects from SOR

People

Show/Hide Data Mapping

COMPANY DIRECTORY

DATA SYNC

RESOURCE PLANNING

QUICK CONNECT

SYSTEM OF RECORD

First Name


First Name


First Name

Last Name


Last Name


Last Name

Status (Active, Inactive)


Status (Active, Inactive)


Record Status or Date Terminated

Employee ID


Employee ID


Employee ID

Mobile Phone


Mobile Phone


Phone /Cell Phone

Email Address


Email Address


Email Address

Job Title


Job Title


Trade Number / Trade ID

N/A

N/A

Tags


Tags

N/A

N/A

Hourly Wage


Pay Rate

N/A

N/A

Date of Birth


Date of Birth

N/A

N/A

Hired Date


Hired Date

N/A

N/A

Gender


Sex

N/A

N/A

Union


Union Number / Union ID

Projects

Show/Hide Data Mapping

PORTFOLIO TOOL

DATA SYNC

RESOURCE PLANNING

QUICK CONNECT

SYSTEM OF RECORD

Project Name


Project Name


Project Name / Description

Status (Active, Inactive)


Status (Active, Inactive)


Job Status

Project Number


Project Number


Job Number

Address


Address 1


Address 1

N/A

N/A

Address 2


Address 2

City


City


City

State

N/A

State


State

ZIP


Postal Code


Zip Code

Timezone


Timezone

N/A

N/A

Start Date


Start Date


Job Start Date

Completion Date


Est. End Date


Completion Date

N/A

N/A

Tags


Tags

N/A

N/A

Customer


Customer Number

N/A

N/A

Project Manager


Project Manager

N/A

N/A

Project Type


Project Class ID

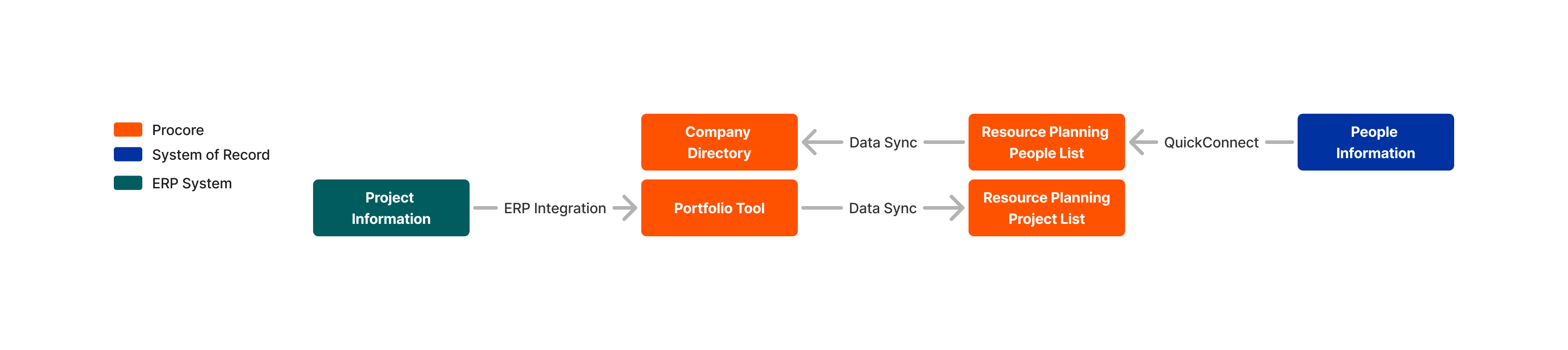

Manage People from your System of Record, Manage Projects from ERP

Customers manage people in a system of record and use QuickConnect to integrate people to Resource Planning. People information then syncs to the Company Directory. At the same time, Customers use an ERP integration to manage project information which syncs to the Portfolio tool. Project information then syncs to Resource Planning.


People

Show/Hide Data Mapping

COMPANY DIRECTORY

DATA SYNC

RESOURCE PLANNING

QUICK CONNECT

SYSTEM OF RECORD

First Name


First Name


First Name

Last Name


Last Name


Last Name

Status (Active, Inactive)


Status (Active, Inactive)


Record Status / Date Terminated

Employee ID


Employee ID


Employee Number

Mobile Phone


Mobile Phone


Phone / Cell Phone

Email Address


Email Address


Email Address

Job Title


Job Title


Trade Number / Trade ID

N/A

N/A

Tags


Tags

N/A

N/A

Hourly Wage


Pay Rate

N/A

N/A

Date of Birth


Date of Birth

N/A

N/A

Hired Date


Date Hired

N/A

N/A

Gender


Sex

N/A

N/A

Union


Union Number / Union ID

Projects

Show/Hide Data Mapping

ERP SYSTEM

ERP INTEGRATION

PROCORE

DATA SYNC

RESOURCE PLANNING

Project Name


Project Name


Project Name

N/A

N/A

Status (Active, Inactive)


Status (Active, Inactive)

Project Number


Project Number


Project Number

Address


Address


Address 1

City


City


City

State


State

N/A

State

ZIP


ZIP


Postal Code

N/A

N/A

Start Date


Start Date

N/A

N/A

Completion Date


Est. End Date

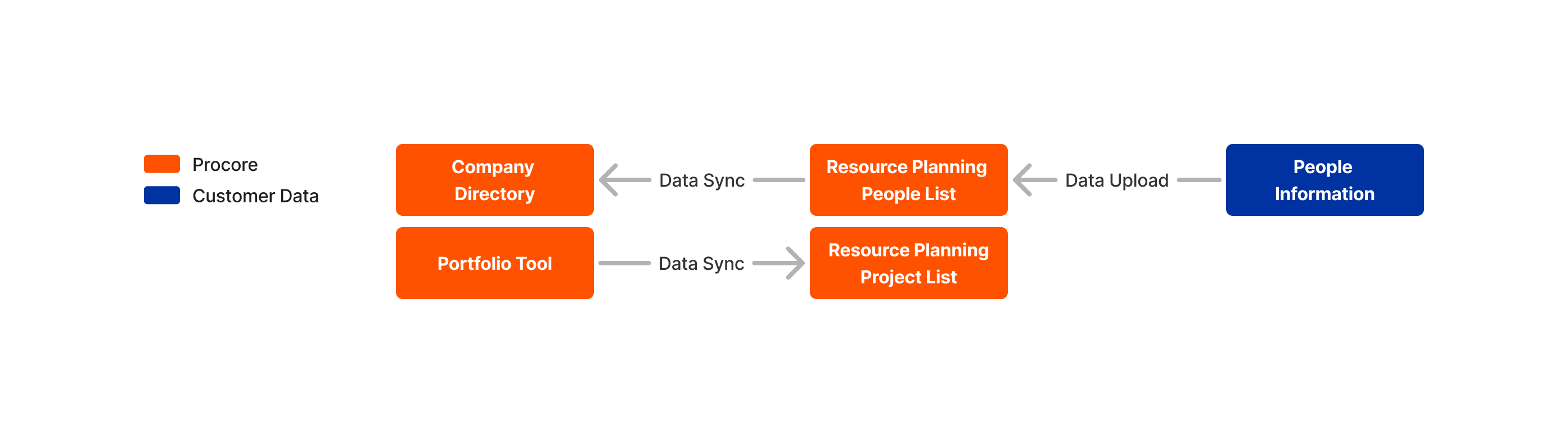

Manage People from Resource Planning, Manage Projects from the Portfolio Tool

Customers can use a one-time data upload to upload their people data into Resource Planning. Going forward, Customers manage people information in Resource Planning which syncs to the Company Directory. Customers manage Project information in the Portfolio tool which syncs to Resource Planning.


People

Show/Hide Data Mapping

COMPANY DIRECTORY

DATA SYNC

RESOURCE PLANNING

DATA UPLOAD

CUSTOMER DATA

First Name


First Name


First Name

Last Name


Last Name


Last Name

Status (Active, Inactive)


Status (Active, Inactive)


Status

Employee ID


Employee ID


Employee ID

Mobile Phone


Mobile Phone


Mobile Phone

Email Address


Email Address


Email

Job Title


Job Title


Job Title (ID)

N/A

N/A

Assignable


Assignable

N/A

N/A

Can receive email


Can receive email

N/A

N/A

Can receive SMS


Can receive SMS

N/A

N/A

Date of Birth


Date of Birth

N/A

N/A

Date of Hire


Date of Hire

N/A

N/A

Emergency Contact Email


Emergency Contact Email

N/A

N/A

Emergency Contact Name


Emergency Contact Name

N/A

N/A

Emergency Contact Mobile Number


Emergency Contact Mobile Number

N/A

N/A

Emergency Contact Relationship


Emergency Contact Relationship

N/A

N/A

Gender


Gender

N/A

N/A

Group


Group (ID)

N/A

N/A

Hourly Wage


Hourly Wage

N/A

N/A

User


User

Projects

Show/Hide Data Mapping

PROCORE

DATA SYNC

RESOURCE PLANNING

Project Name


Project Name

Status (Active, Inactive)


Status (Active, Inactive)

Stage


Job Stage

Project Number


Project Number

Address


Address 1

City


City

ZIP


Postal Code

Timezone


Timezone

Start Date


Start Date

Completion Date


Est. End Date
