Set Up Submittal Schedule Calculations

Background

Submittal Schedule Calculations is an optional configuration feature that can be enabled for use with the Project level Submittals tool. When enabled on a Procore project, this option analyzes these key dates, which are entered by the creator under Submittal Schedule Information in a submittal package or a submittal item:

  • Required On-Site Date

  • Lead Time

  • Design Team Review Time

  • Internal Review Time

After analyzing the date entries, Procore automatically populates the calculated date values for the end user in the following fields:

  • Planned Return Date

  • Planned Internal Review Completed Date

  • Planned Submit By Date

Based on the calculated date values above, Procore also suggests dates for the following fields:

  • Submitter Due Date

  • Approver Due Date

This helps the submittal creator ensure that submittal packages and items submitted to the review team are approved on schedule.

Things to Consider

  • Required User Permissions:

    • To create a submittal that uses these calculations, 'Standard' level permissions to the Submittals tool.

    • To define the calculations used on the project, 'Admin' level permissions to the Submittals tool.

  • Prerequisite:

  • Additional Information:

    • Schedule calculations do NOT automatically populate due dates in the submittal workflow.

Steps

  1. Follow the steps in Create a Submittal.
    This reveals the New Submittal page.

  2. Scroll down to the Submittal Schedule Information area.

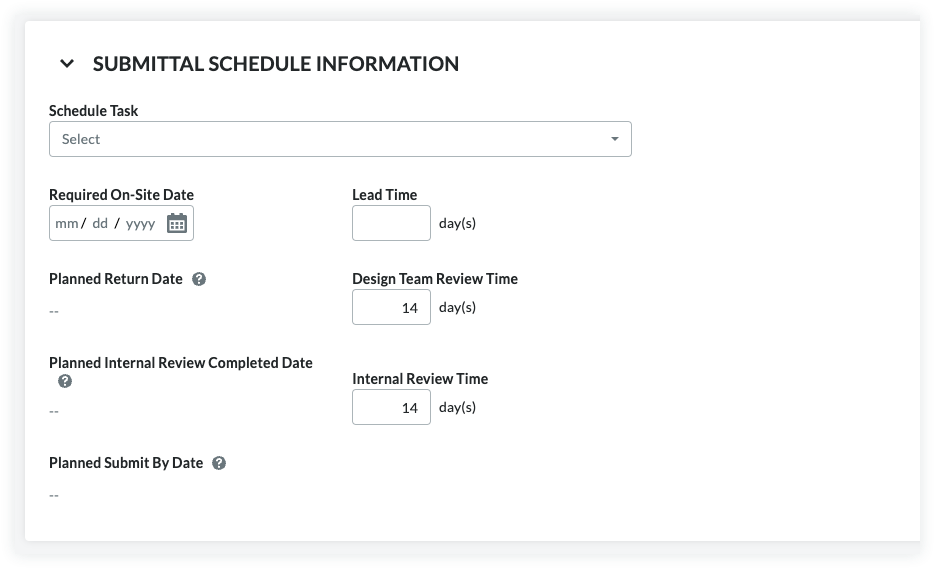

  3. Set the following information:

    1. Schedule Task. The schedule task associated with the submittal being created. A schedule must be uploaded to the project first. See Upload a Project Schedule File to Procore's Web Application.

    2. Note: If you enter 7, the system subtracts '7' calendar days from the Planned Return Date to automatically populate the date entry for the Planned Internal Review Completed Date.

    3. Note: If you enter 10, the system subtracts '10' calendar days from the Required On-Site Date to automatically populate the date entry for the Planned Return Date.

    4. N ote: If you enter 5, the system subtracts '5' calendar days from the Planned Internal Review Completed Date to automatically populate the date entry for the Planned Submit by Date.

Example:
